Meziadin Pipe Push
CLIENT
DRM
VALUE
$2.3M
DURATION
Sep 2025-Nov 2025
Project Scope
West of Surprise Pit – based on an 10 day pipe installation, 22 day total on site
- Build access inlet side, create bypass pumping pad, entrance pit (trucking of spoil and supply of granular by DRM)
- Build access outlet side, receiving pit, realign channel (trucking of spoil and supply of granular by DRM)
- Rip Rap placement, inlet and outlet (supply/delivery by DRM)
- Grout Abandoned Culvert
- Bypass Water Pumping

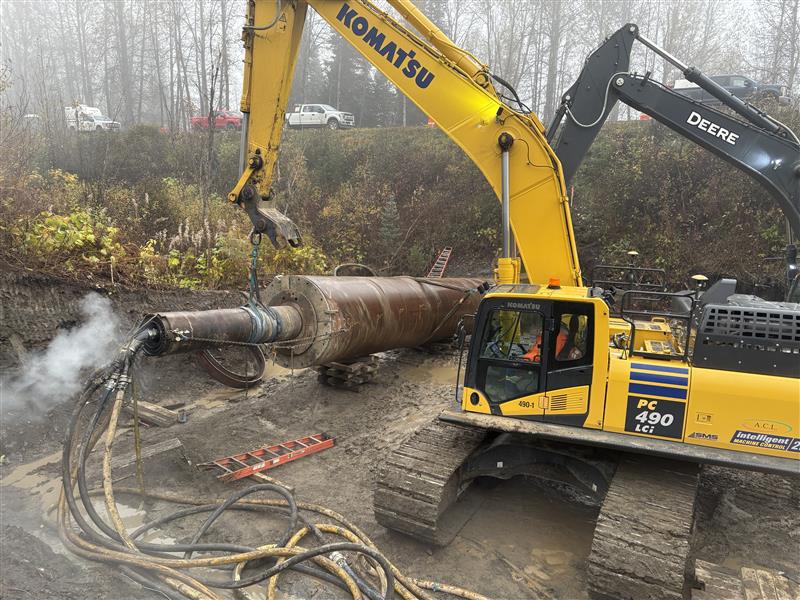

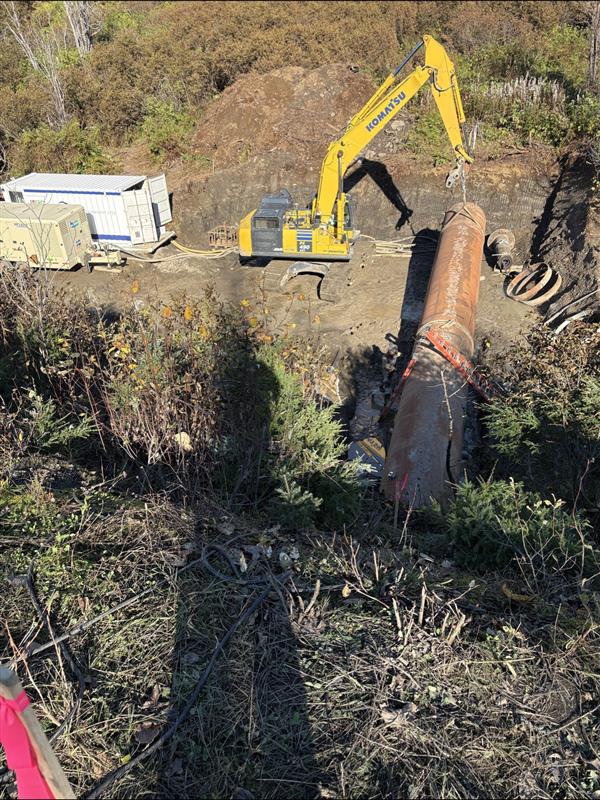

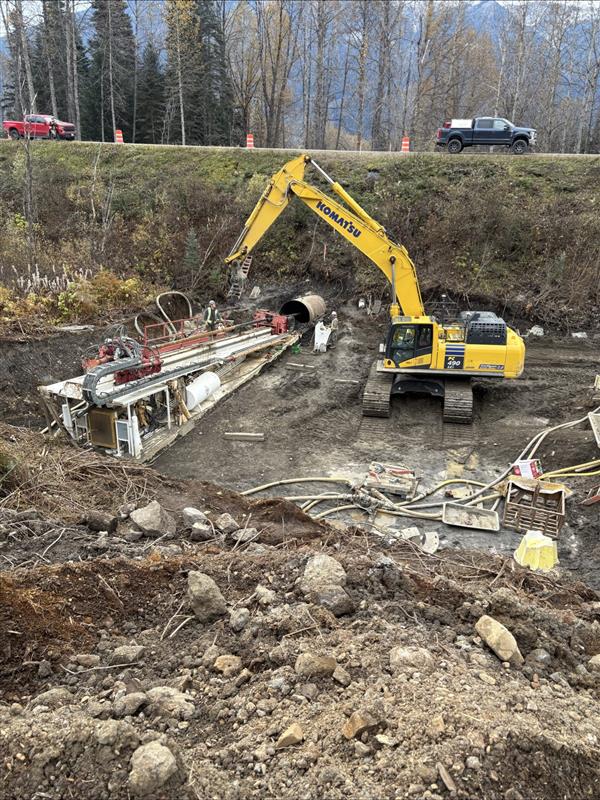

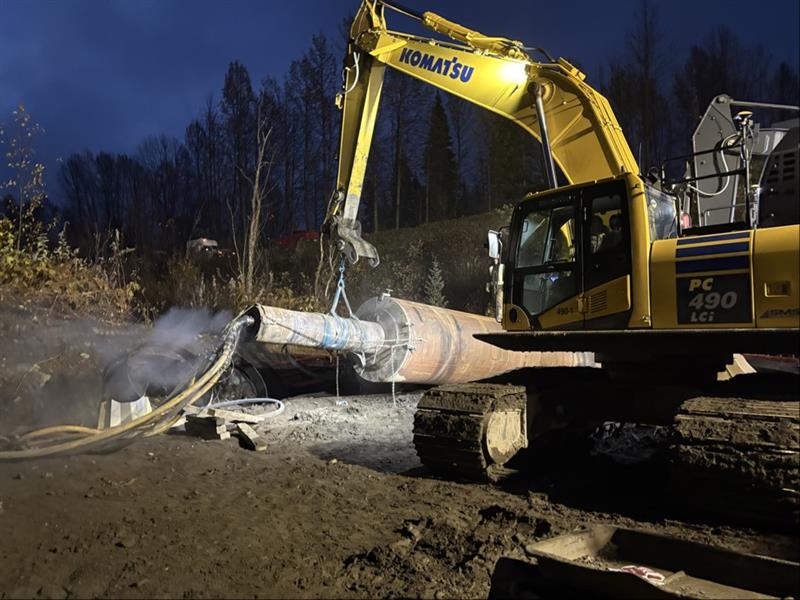

- Supply & Install 60” x 36m pipe
Lakeview Corner – based on an 10 day pipe installation, 22 day total on site
- Build access inlet side, create bypass pumping pad, entrance pit (trucking of spoil and supply of granular by DRM)
- Build access outlet side, receiving pit, realign channel (trucking of spoil and supply of granular by DRM)
- Rip Rap placement, inlet and outlet (supply/delivery by DRM)
- Grout Abandoned Culvert
- Bypass Water Pumping
- Supply & Install 72” x 45m pipe
Roles & Responsibilities
Challenge
Limited geology showing fill and rock formation, potential challenge in installation rate and risk of encountering boulder and large size rock
ACL Solution
Up size the gauge of the steel culvert in case structures were encountered
Highlight / Achievement
Both replacements were successful with minimal complications
Team Size on Site
4-5 ACL crew, sub contractors on site (4 people) & traffic control
Sustainability Certifications
Environmental
Subcontractor(s)
N/A
Let’s get your project off the ground!
From site preparation and underground utilities to road building and large-scale infrastructure work, our team will work with you to deliver practical solutions that align with your goals, timeline, and budget.
Start a Conversation
